Dupont Shift Schedule

DESCRIPTION:
This rotating shift pattern uses 4 teams and two 12-hour shifts to provide 24/7 coverage.

OBJECTIVE:
To cover round the clock operation and it is used in several manufacturing industries and police departments.

RULES:
1.   Requires 4 teams
2.   4-week cycle where each team works 4 consecutive night shifts, followed by 3 days off duty, works 3 consecutive day shifts, followed by 1 day off duty, works 3 consecutive night shifts, followed by 3 days off duty, work 4 consecutive day shift, then have 7 consecutive days off duty
3.   Personnel works an average 42 hours per week.

PROCESS: Download PDF version
 STEP 1

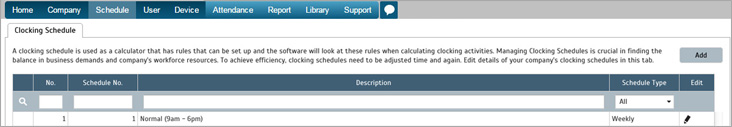

Select Clocking Schedule under the Schedule tab.

 STEP 2

Click Add icon on the right corner of the page.
[ Click here for larger view ]

You will see:
[ Click here for larger view ]

 STEP 3

1. Fill up the Schedule No for example 401
2. Describe the schedule: DuPont Shift Schedule - Day shift
3. Select Schedule Type: Daily
4. Set the time: Start at 7am and end at 7pm – 12 hours
5. Make sure you properly select the other fields like Range, General, Rounding and etc, based on your company’s attendance’s rules and policies.
[ Click here for larger view ]

6. Repeat the steps for Night Shift
7. Give another Schedule No: 402
8. The time for Night Shift will start at 7pm and done at 7am
9. Submit the Schedule.
[ Click here for larger view ]

 STEP 4

Now that the clocking schedules for DuPont Shift Schedule have been established, let’s proceed to the Group Duty Roster where you apply this daily schedule to a working yearly calendar.

Under Schedule tab select Assign Users to Duty Roster.


Click button Add to add the new DuPont Shift Schedule to a new Group Duty Roster
[ Click here for larger view ]

 STEP 5

1.   Fill up Group No – Put any number for example 401
2. Describe the Duty Group
3. Select Group Type: Shift
4. Select Auto and the Auto Schedule Assistant will appear as below
5. Select the Day Type and its corresponding Shift. It has to follow this pattern of 28 days:

Team A
Night, Night, Night, Night, rest, rest, rest, Day, Day, Day,
rest, Night, Night, Night, rest, rest, rest, Day, Day, Day,
Day, rest, rest, rest, rest, rest, rest, rest

Team B
Day, Day, Day, rest, Night, Night, Night, rest, rest, rest,
Day, Day, Day, Day, rest, rest, rest, rest, rest, rest, rest,
Night, Night, Night, Night, rest, rest, rest

Team C
Rest, rest, rest, Day, Day, Day, Day, rest, rest, rest, rest,
rest, rest, rest, Night, Night, Night, Night, rest, rest, rest,
Day, Day, Day, rest, Night, Night, Night

Team D
Rest, rest, rest, rest, rest, rest, rest, Night, Night, Night, Night,
rest, rest, rest, Day, Day, Day, rest, Night, Night, Night,
rest, rest, rest, Day, Day, Day, Day,


6   Select your Effective Date to start the schedule and click Apply. Your Duty Group will look like the one below:
Team A Duty Roster
[ Click here for larger view ]

Team B Duty Roster
[ Click here for larger view ]

Team C Duty Roster
[ Click here for larger view ]

Team D Duty Roster
[ Click here for larger view ]

Disadvantages of this schedule is, teams must work 72 hours in one week in every 4 weeks, and the shift length is up to 12 hours. It also requires an average of two overtime hours per employee per week.
